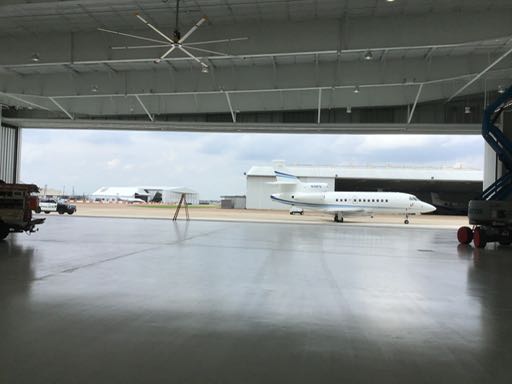

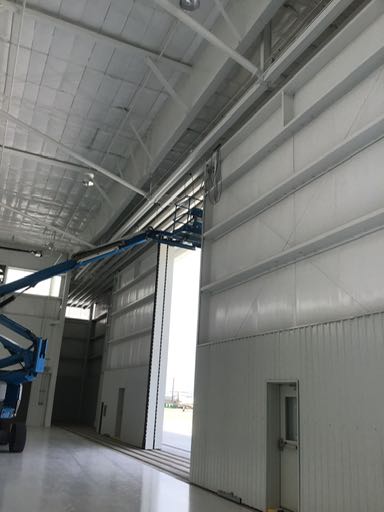

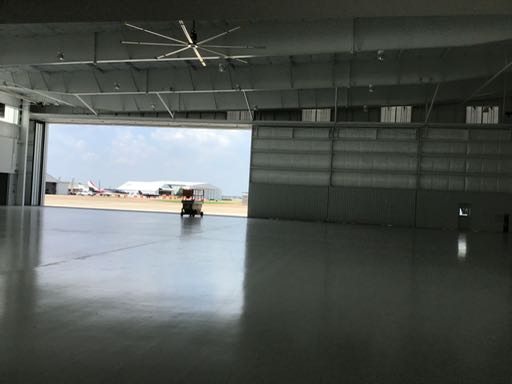

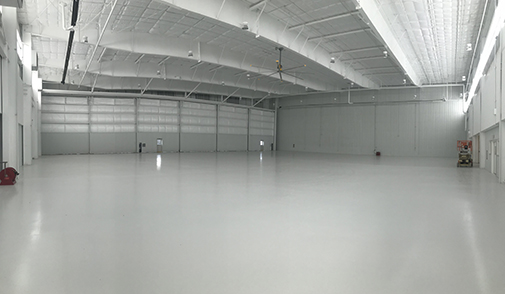

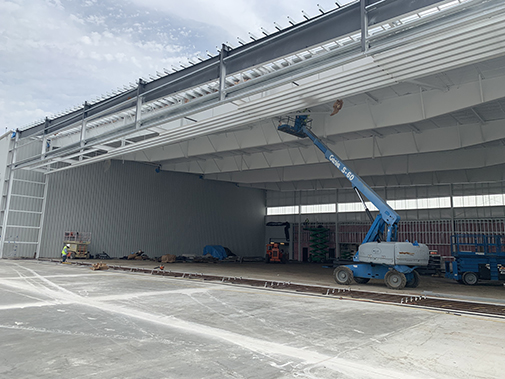

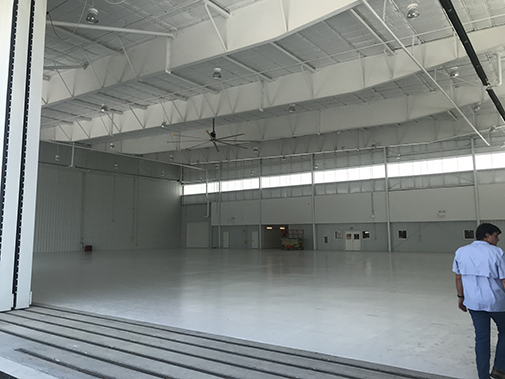

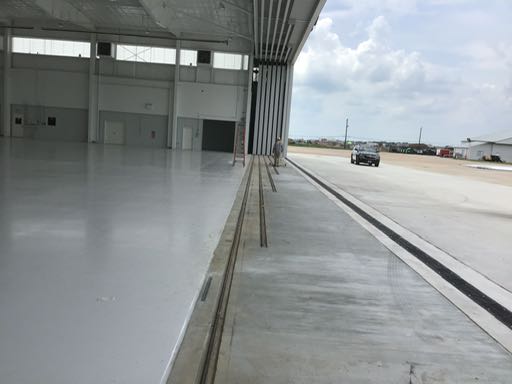

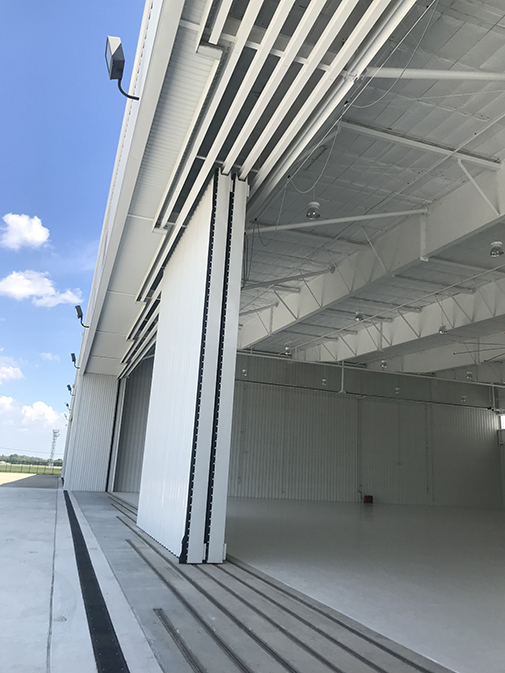

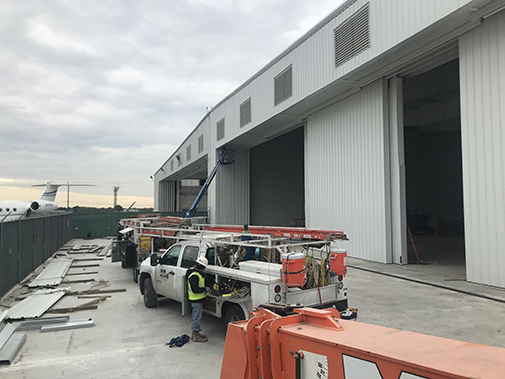

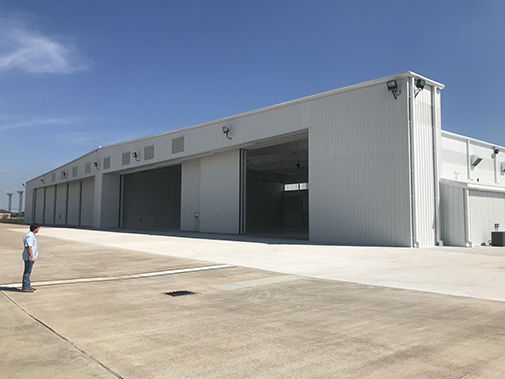

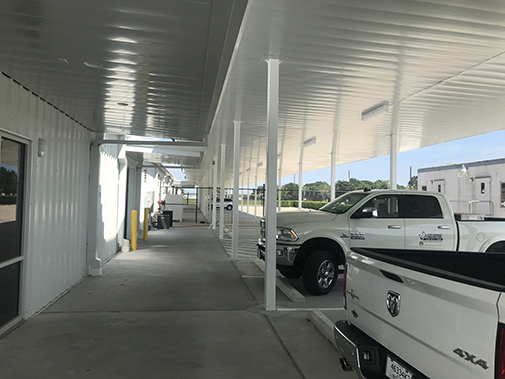

9.05.19 - Crews completed their work on the hangar doors and have finished the trim. Their work on this project is complete,

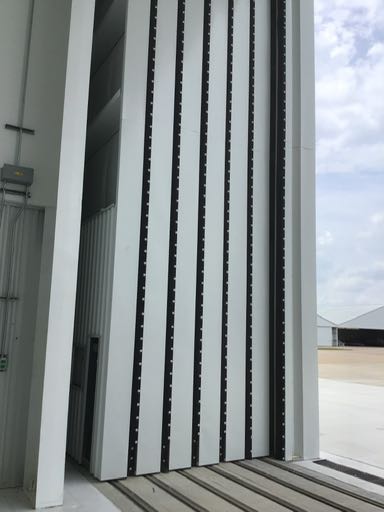

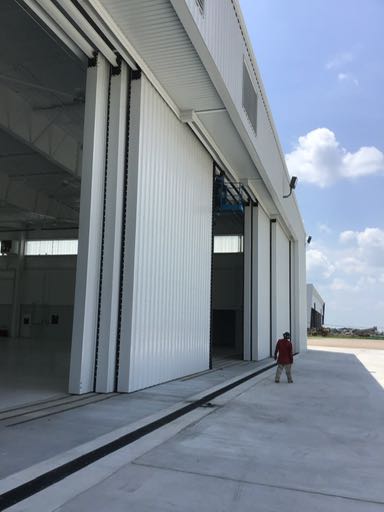

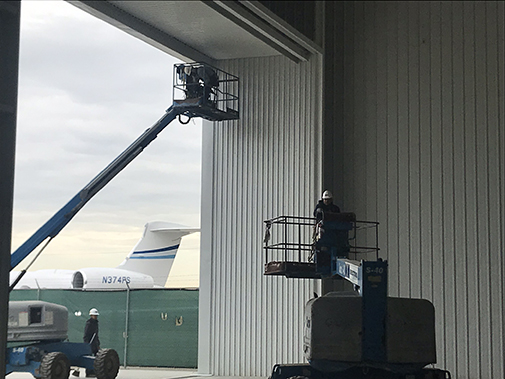

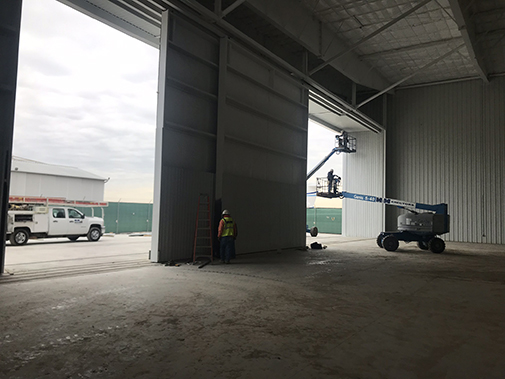

9.03.19 - Crewmen worked on the rolling hangar doors so group 3 could open and close independently of group 6. Crewmen repaired the weatherstrip after separating the sections of rolling door. Crewmen also installed trim between the existing building and the purlins,

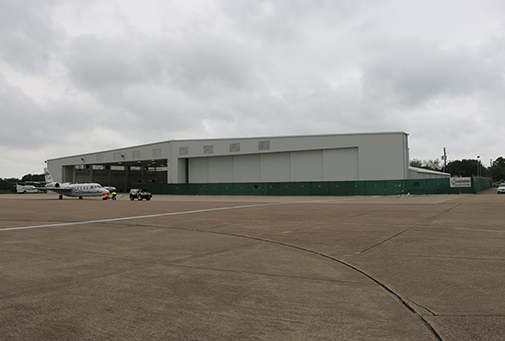

6.07.19 - Crews installed trim around the columns and soffit,

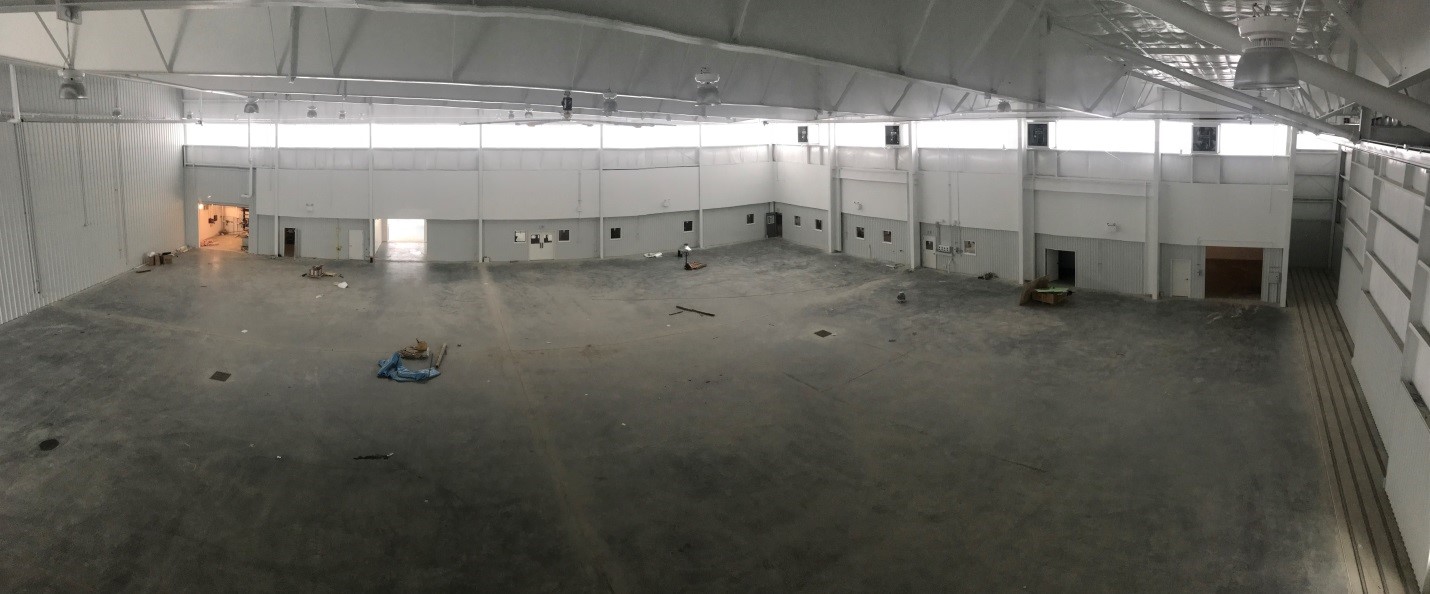

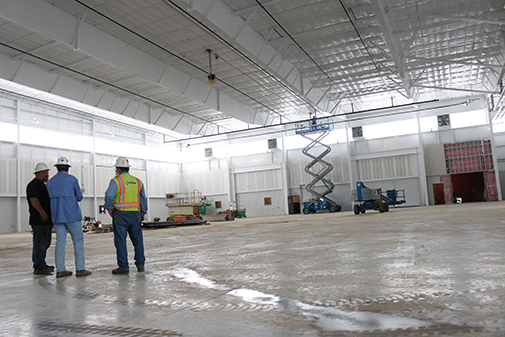

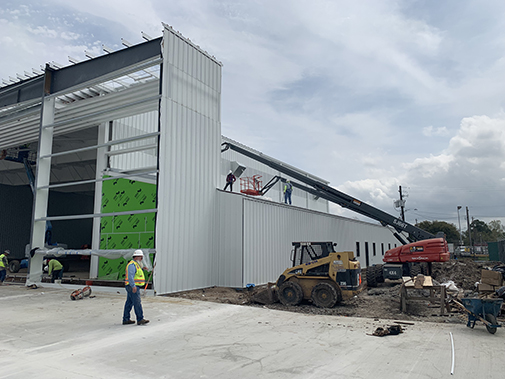

4.19.19 - Interior sheeting continues,

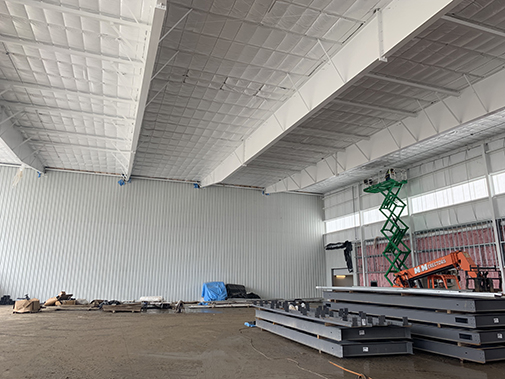

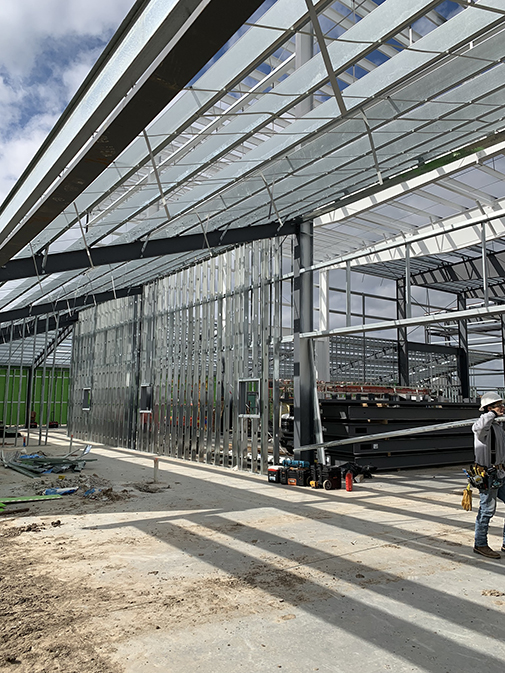

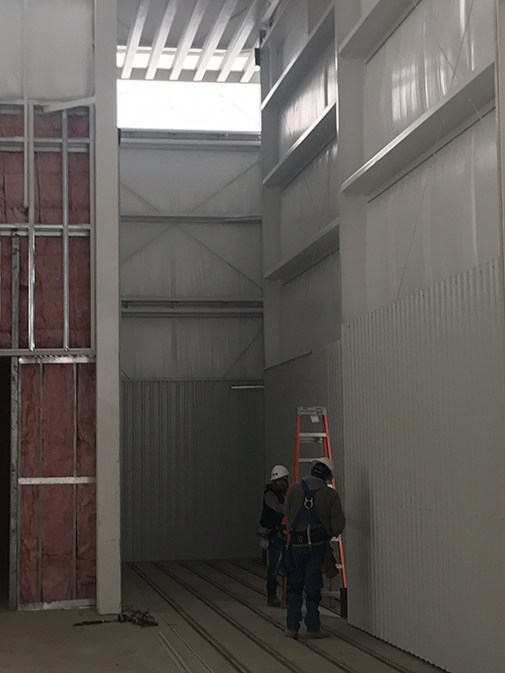

4.01.19 - Crewmen are installing liner panels on the interior hangar walls, and are trimming and sheeting the rolling doors,

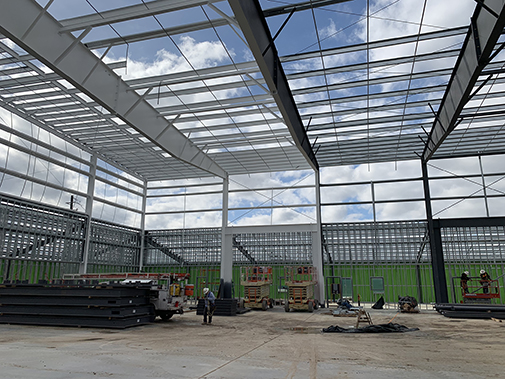

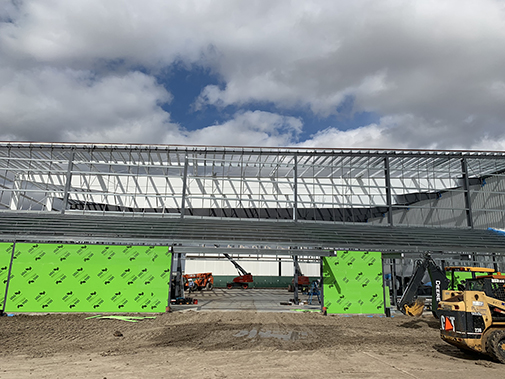

3.11.19 - Crewmen have progressed to installing insulated roof sheeting,
1.21.19 - Crewmen are installing the insulation straps,

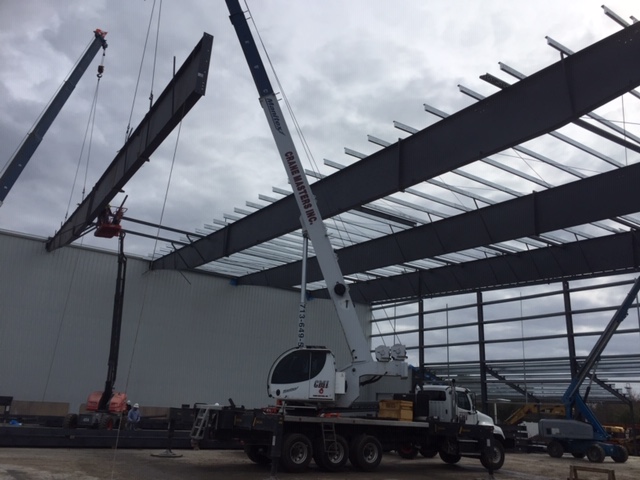

1.07.19 - Crewmen progressed to hanging rafters,

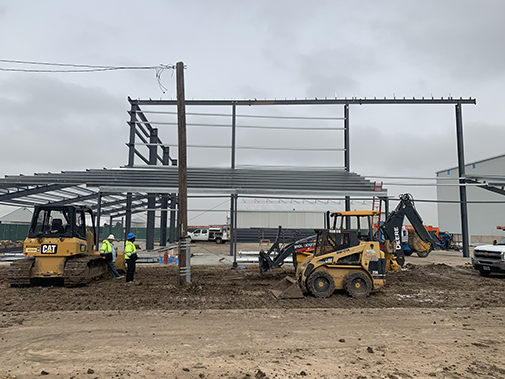

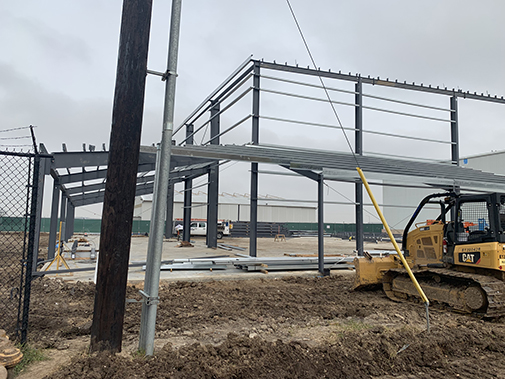

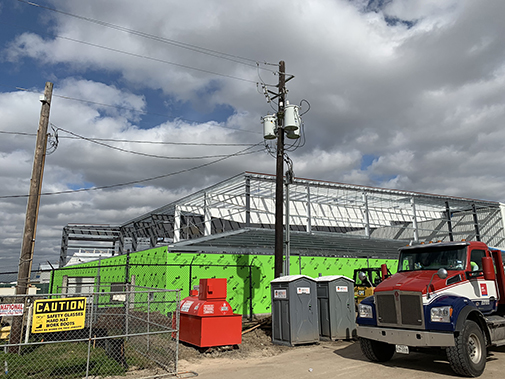

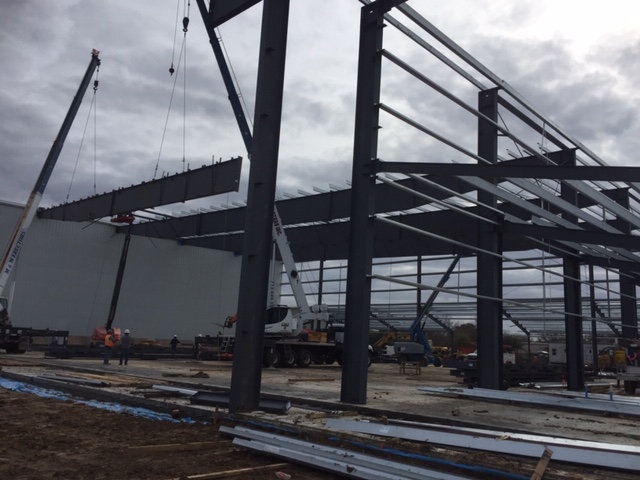

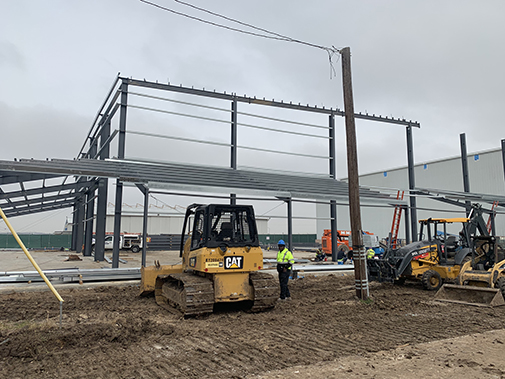

12.18.18 - Crewmen began hanging steel for the new section of hangar last Thursday. Below is progress as of today,
